Moorebank Intermodal Freight Terminal

Moorebank Intermodal Freight Terminal

Greg Fulmer

|

April 9, 2025

Client

Georgiou

Location

Moorebank, NSW

Value

$8 Million

Completed

July 2022

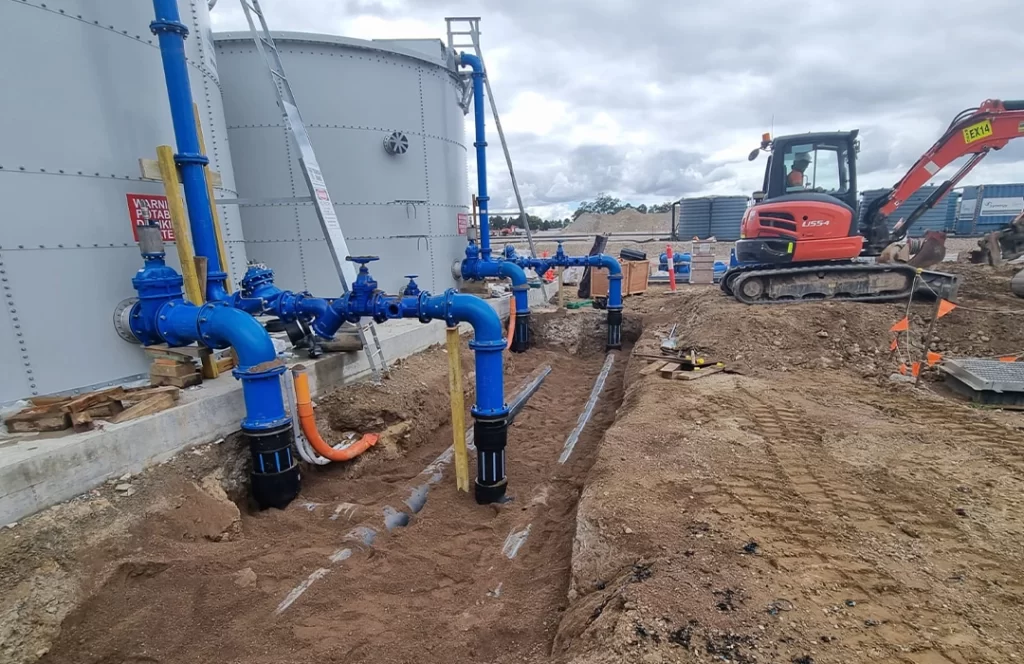

A construction site with blue industrial pipes connected to a large storage tank, an orange excavator, and exposed ground.A construction site with blue industrial pipes connected to a large storage tank, an orange excavator, and exposed ground.

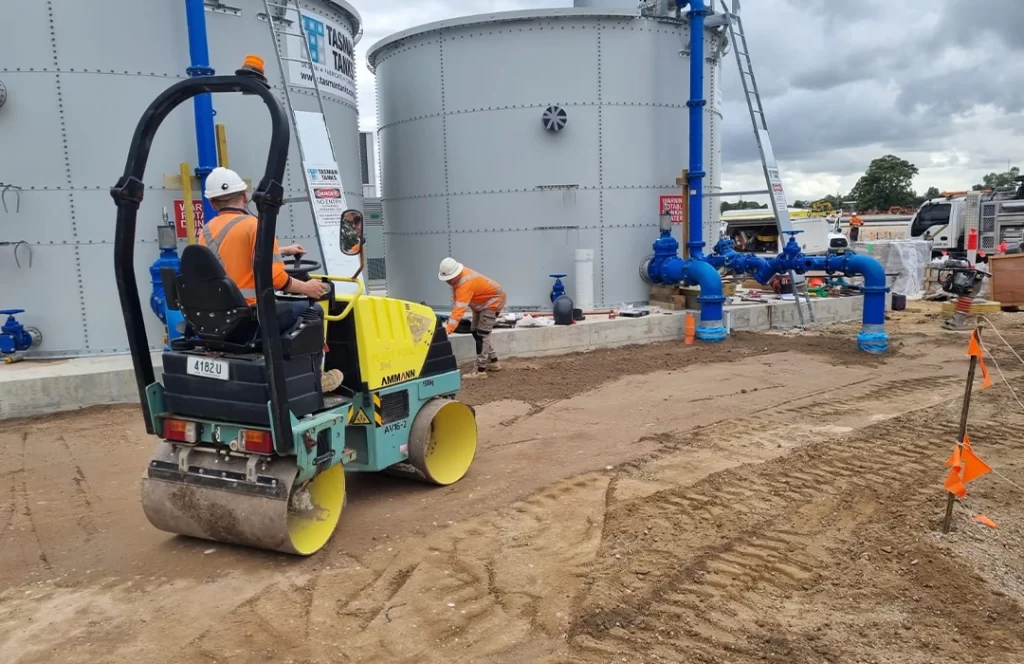

Two construction workers in safety gear work near large metal tanks; one operates a small road roller on a dirt surface, while the other works near blue pipes and site equipment.Two construction workers in safety gear work near large metal tanks; one operates a small road roller on a dirt surface, while the other works near blue pipes and site equipment.
Industrial site with large pipes wrapped in blue plastic, concrete barriers, safety railings, and a building with yellow accents in the background under a partly cloudy sky.Industrial site with large pipes wrapped in blue plastic, concrete barriers, safety railings, and a building with yellow accents in the background under a partly cloudy sky.

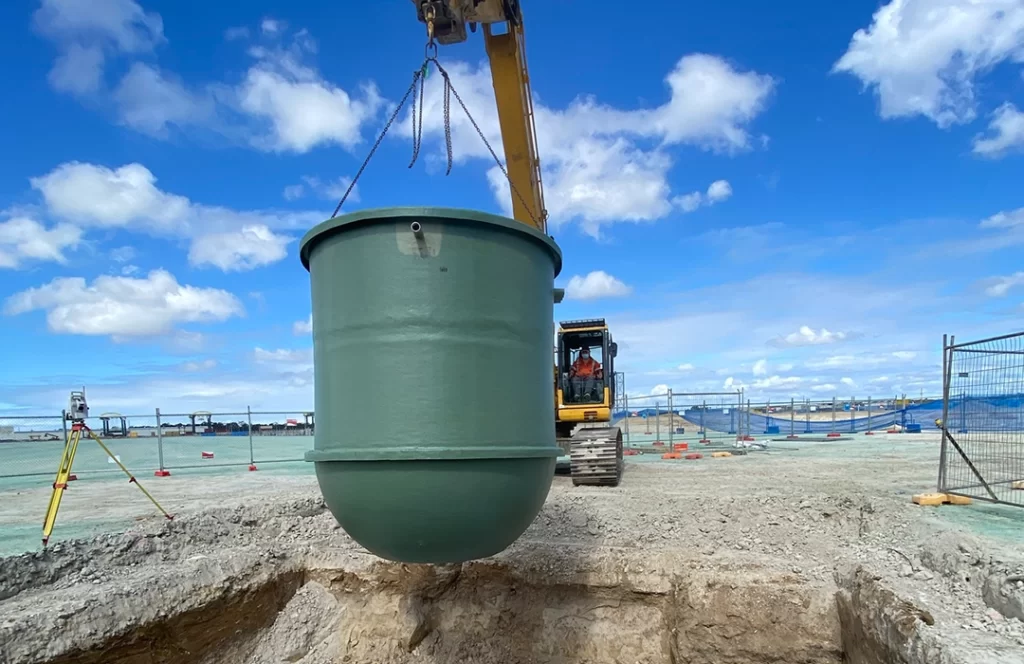

A construction vehicle lifts a large green cylindrical tank over a dirt excavation site under a partly cloudy sky.A construction vehicle lifts a large green cylindrical tank over a dirt excavation site under a partly cloudy sky.

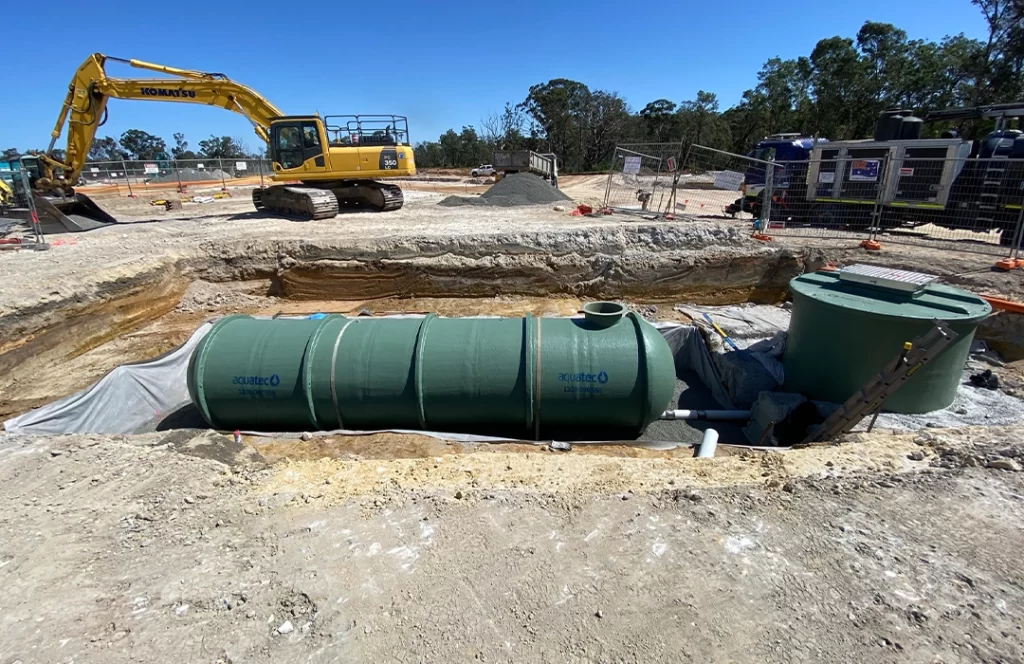

A large green underground water tank is being installed at a construction site, with an excavator and construction materials visible in the background.A large green underground water tank is being installed at a construction site, with an excavator and construction materials visible in the background.

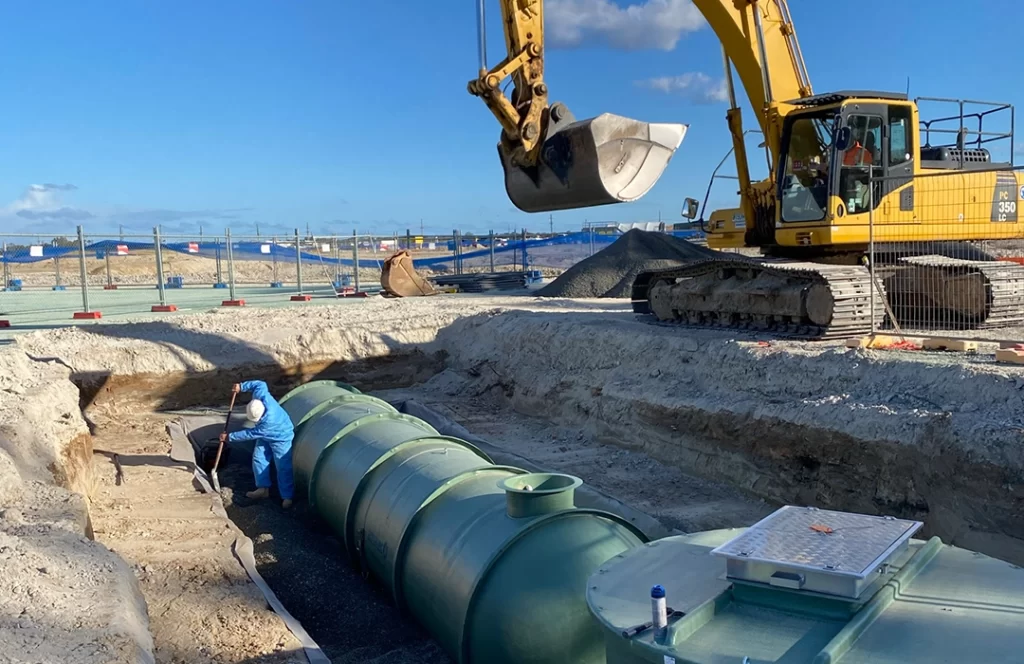

Construction worker in blue coveralls installs large green storage tanks in a trench as a yellow excavator operates nearby on a construction site.Construction worker in blue coveralls installs large green storage tanks in a trench as a yellow excavator operates nearby on a construction site.

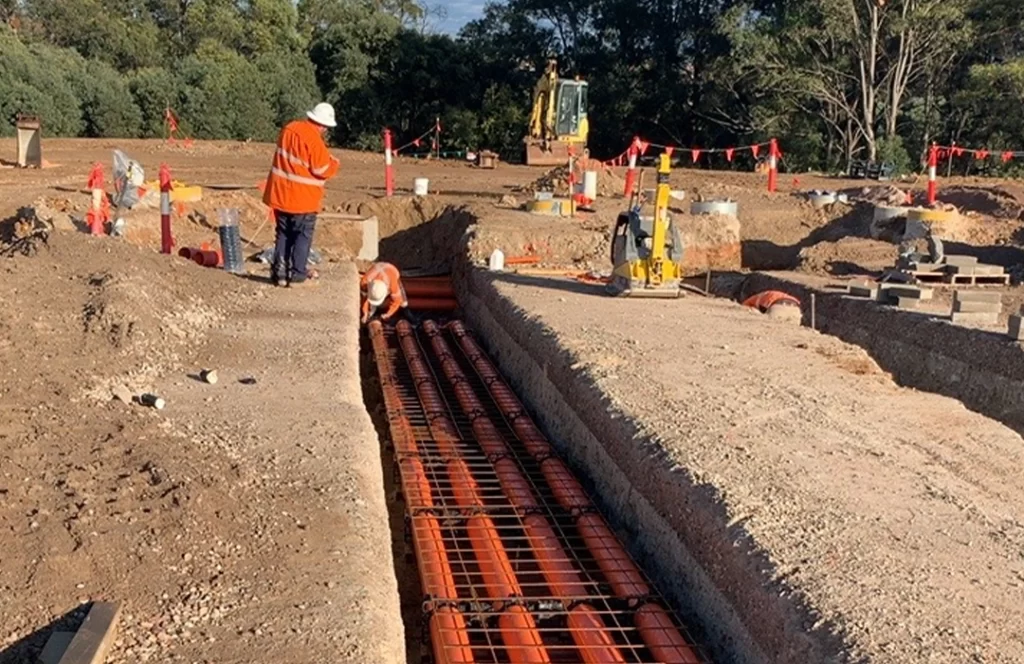

Construction workers in high-visibility clothing install orange utility pipes in a trench, surrounded by dirt and construction equipment.Construction workers in high-visibility clothing install orange utility pipes in a trench, surrounded by dirt and construction equipment.

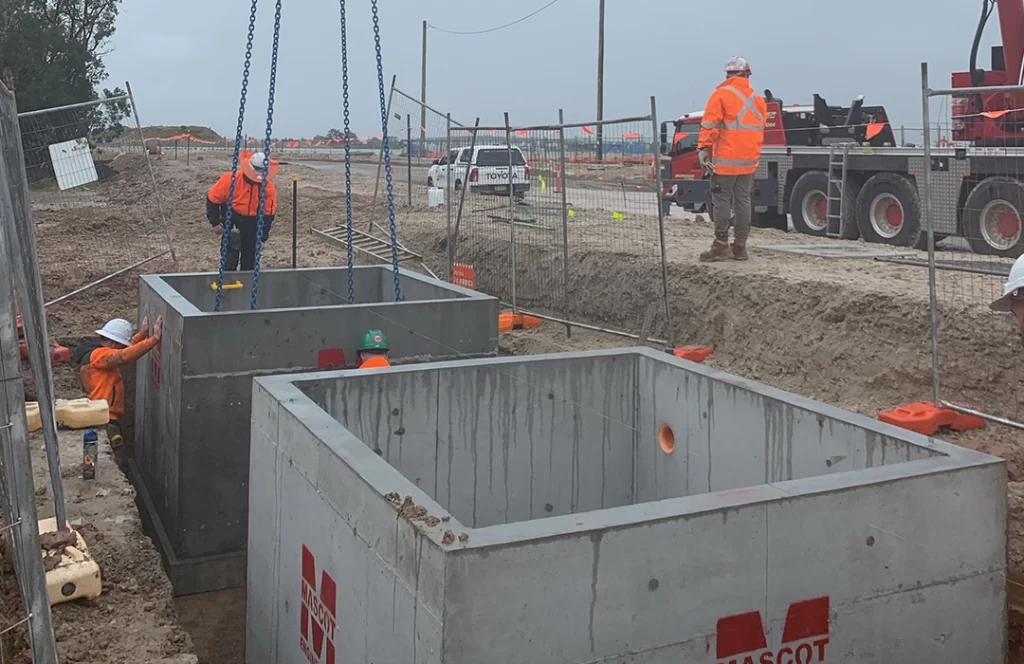

Construction workers in high-visibility clothing install large concrete utility boxes in a trench at a worksite using a crane. Safety barriers and vehicles are visible in the background.Construction workers in high-visibility clothing install large concrete utility boxes in a trench at a worksite using a crane. Safety barriers and vehicles are visible in the background.
Excavators and construction vehicles work at a construction site with a large concrete pipe being installed in a deep trench.Excavators and construction vehicles work at a construction site with a large concrete pipe being installed in a deep trench.

A series of blue industrial pipes and valves connected to a building, with additional black and orange pipes running underground in a trench.A series of blue industrial pipes and valves connected to a building, with additional black and orange pipes running underground in a trench.

Project Overview

Moorebank Intermodal utilities across Stage 2 of the precinct

RA Smith Contracting delivered the Moorebank Intermodal utilities for Georgiou across Stage 2 of the precinct in NSW. The work covered site-wide stormwater drainage, potable water, pressure sewer and fire hydrant services, plus conduits to each proposed warehouse.

The contract began at slightly less than $2 million for stormwater drainage and grew to $8 million as Georgiou awarded more work. Site work took place from January 2021 to July 2022. Work like this is part of our stormwater services and water construction services.

The Moorebank Intermodal Terminal Precinct has a rail shuttle link to Port Botany and more than 850,000 m2 of warehousing.

January 2021 – July 2022

The Challenge

Flooding, unbuilt retention ponds and a growing contract

Stage 2 needed several utility networks built at once across a developing industrial site. Much of the in-ground work fell in a period of extreme wet weather across the Sydney metropolitan region.

The first stormwater pipework discharges to on-site retention ponds. The ponds had not been built, so the pipework was capped. In the rain the system backed up and overflowed, and parts of the site flooded significantly.

The scope also kept growing. The contract began with stormwater drainage, and Georgiou added hydraulic services and further utility work as requirements changed. Resources, sequencing and delivery kept adjusting across several work fronts.

The Solution

Staged delivery and close coordination with Georgiou

We worked closely with Georgiou and the other stakeholders so each new stage of work fitted into the program as requirements changed.

Flood response. RA Smith worked with Georgiou to limit the effect of the flooding on the installed services and the wider site. The aim was to get every contractor on site back to work faster after heavy rain.

Staged delivery. Stormwater drainage went in from January to July 2021. The water, sewer and fire services followed from November 2021 to July 2022.

Scope growth and coordination. The team folded each addition into the program and coordinated with Georgiou and the other on-site contractors.

Project Outcome

Stage 2 utilities delivered, contract grown to $8 million

RA Smith delivered the stormwater, potable water, pressure sewer and fire hydrant services for Stage 2. The contract grew from slightly under $2 million to $8 million.

Key Outcomes

  • Stormwater, potable water, pressure sewer and fire hydrant services delivered across Stage 2
  • Primary stormwater network installed in three sections, with CCTV of all pipes and pits after construction
  • About 5,400m of potable water main, 4,180m of pressure sewer and 2,600m of fire hydrant service installed
  • Permanent connection made to the Sydney Water main beyond the site boundary
  • Conduits for electrical, communications and gas run to each proposed warehouse
  • Works coordinated with Georgiou and the other on-site contractors through to July 2022
  • Contract grew from slightly under $2 million to $8 million as Georgiou awarded more work

On the Moorebank Intermodal utilities, Georgiou saw how RA Smith handled the initial scope and awarded significant additional work. The team stayed on site across the whole of Stage 2. Our Integrated Management System is third party accredited to AS/NZS ISO 9001:2015, ISO 45001:2018 and ISO 14001:2015.

Moorebank Intermodal Freight Terminal Case Study

PDF · Full technical scope

Technical Scope

What the works involved

Stormwater Drainage

  • Primary stormwater network installed site-wide in three sections, with pipe from 375mm to 1650mm diameter, to depths of 4.5m
  • SP1 (R5): about 1.891km of pipeline in trenches 1.5m to 4.5m deep, with 62 precast concrete pits
  • SP2 (R6): about 1.672km of pipeline in trenches 1.5m to 3.5m deep, with 53 precast concrete pits
  • SP3 (R8): about 471m of pipeline in trenches 1.5m to 3.5m deep, with 20 precast concrete pits
  • Class 4 RJ pipe, with pits fitted with block outs and step irons
  • CCTV inspection of all pipes and pits after construction
  • In-ground connections to the primary stormwater carrier pits for each future warehouse roof, with drainage to the on-site detention areas

Potable Water and Fire

  • About 5,400m of pressurised PE potable water main, 32mm to 250mm diameter, with valves and fittings
  • Potable cold water storage and booster pumps, including two tanks, pumps and valving
  • Permanent connection to the Sydney Water main immediately beyond the site boundary
  • About 2,600m of 250mm PE fire hydrant service with valves and fittings throughout Stage 2
  • Water connections for each future building stage, and fire hydrants throughout the site

Pressure Sewer

  • About 4,180m of pressure sewer, 65mm to 110mm diameter
  • Valves, flushing points and connections
  • Sewer systems and pumping equipment to manage facility wastewater

Warehouse Utilities

  • Conduit from the main utilities distribution point to each proposed warehouse location
  • Low voltage electrical, communications and fibre optic, and gas services
  • Drainage to the proposed warehouse building ground slabs

FAQs

Moorebank Intermodal Freight Terminal FAQs

What did RA Smith build at the Moorebank Intermodal Terminal Precinct?

RA Smith installed the primary stormwater network, potable water mains, pressure sewer and fire hydrant services across Stage 2 for Georgiou, plus conduits to each proposed warehouse.

How much pipe did RA Smith install across Stage 2?

About 5,400m of PE potable water main, 4,180m of pressure sewer and 2,600m of PE fire hydrant service, plus three sections of primary stormwater pipe from 375mm to 1650mm diameter.

Why did the Moorebank stormwater system flood?

The first stormwater pipework discharges to on-site retention ponds that had not been built, so it was capped. In extreme wet weather the system backed up and overflowed.

How deep is the Moorebank stormwater pipe?

The trenches are 1.5m to 4.5m deep in the first section and 1.5m to 3.5m deep in the other two.

How did the Moorebank contract grow from under $2 million to $8 million?

It started as a stormwater drainage contract of slightly less than $2 million. Georgiou awarded significant additional work after RA Smith performed the first scope, including hydraulic services and warehouse utility conduits.
